Project Update (June 2022)

Current Construction Activity

231018-00 Renovations to Dana Hall

Substantially complete subject to Final Punchlist items.

American School & University - Outstanding Design - Specialized Facility

231032-00 Replace Switchgear and Electrical Panels, Wicks and MacArthur Halls

Ongoing. Substantial completion expected mid-July 2022.

231033-00 Upgrade French Hall Plaza

Ongoing. Substantial completion expected mid-June 2022.

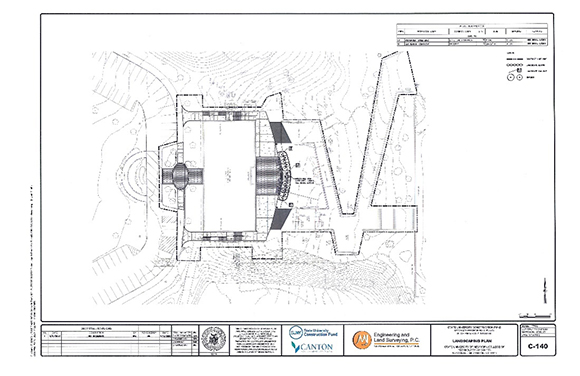

French Hall Plaza

231033-01 Upgrade French Hall Plaza Phase II

Pending Contractor Notice to Proceed. Project start and scheduled to be determined.

French Hall Plaza project

231038-00 Reconstruct Cooper Service Complex Parking Lot

Ongoing. Substantial completion expected the end of June 2022.

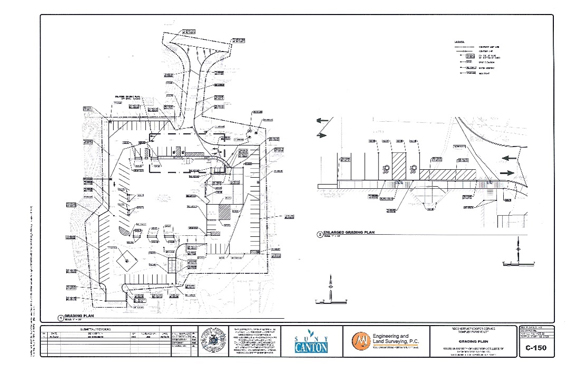

Cooper Service Complex Parking Lot

231041-00 Minor Critical Maintenance FY 2020-21

  • M23654 Substation Repair – Switchgear Remediation – Ongoing.  Substantial completion expected the end of June 2022.
  • M23676 Payson Hall Replace Combustion Air Heating Coil – Ongoing.  Substantial completion expected the end of June 2022.
  • M23681 Repair Fascia & Soffit @ Overhead Door Cooper Service Complex – Pending availability of materials.

231046-00 Minor Critical Maintenance FY 2021-22

  • M23697 Replace VFD's Supply Air Fans MacArthur Hall – Pending availability of materials.
  • M23709 Remove and Replace Damaged Light Pole – Pending availability of materials.
  • M23711 Siemens BLN Upgrades – Ongoing. Substantial completion expected mid-August 2022.
  • M23712 CARC Replace VESDA Fire Alarm Systems – Ongoing.  Substantial completion expected mid-August 2022.
  • M23713 Repair Deteriorated Plaster CARC Swimming Pool – Project start / completion expected September 2022.

231047-00 Renovate Center for Criminal Justice, Intelligence & Cybersecurity - Dana Hall

Substantially complete subject to Final Punchlist items.

L23151 Nevaldine Hall - Upgrade Card Access Control

Project start and schedule to be determined. Substantial completion expected mid-August 2022.

L23156 Replace Rendezvous Store Front - MCC

Project start and schedule to be determined. Substantial completion expected mid-August 2022.

L23161 Replace Lighting Convocation Athletic Recreation Center (CARC)

Project start and schedule to be determined. Substantial completion expected mid-August 2022.

L23162 Heritage North 1st and 3rd Floor Replacements

Project start and schedule to be determined.  Substantial completion expected mid-August 2022.

L23164 Kennedy Hall Parking Lot Repair

Project scheduled to start mid-June. Substantial completion expected the end of June 2022.

Projects - Design Phase

231042-00 Replace HVAC – French Hall

Bid Phase expected June 2022. Construction start expected September 2022.

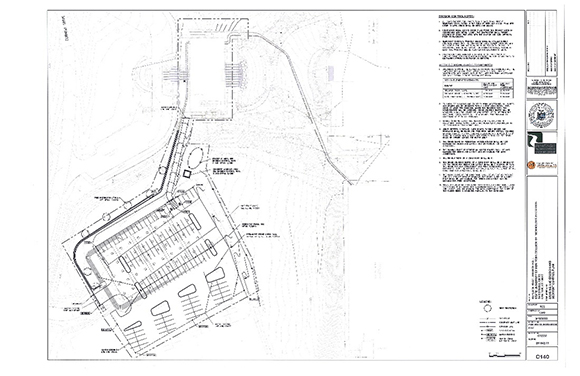

French Hall HVAC drawing

231044-00 Improve Accessibility – Nevaldine North & South

Bid Phase expected June 2022. Construction start to be determined.

Nevaldine Accessibility Updates

231046-00 Minor Critical Maintenance FY 2021-22

M23710 Wicks Hall – Exterior Façade Restoration – Bid Phase expected June 2022. Construction start to be determined.

231048-00 Replace Roofs - Chaney and MacArthur Halls

Bid Phase to be determined.

Chaney Proposed New Entrance

Chaney Proposed New Entrance

231049-00 Clean Energy Master Plan

Ongoing. Project start March 2022.

The Climate Leadership and Community Protection Act (CLCPA), enacted in 2019, includes a requirement for New York State to reduce statewide greenhouse gas emissions by 85 percent by 2050. Given its size, SUNY will need to play a large part in helping the State achieve these goals. In an effort to facilitate a comprehensive planning effort, the State University Construction Fund has partnered with NYSERDA to become the lead grantee on behalf of the state-operated campuses and statutory colleges to conduct Clean Energy Master Plans (CEMP).

These CEMPs will provide the campus a roadmap to achieve the CLCPA goals, with supporting information to identify and recommend building upgrades and improvements to reduce energy use and carbon. The plans will assess heating plant level efficiency improvements, load reduction strategies, beneficial electrification, and discover opportunities to decarbonize heating and cooling. The CEMP will include multiple financially viable, realistic scenarios, and a multi-year phased approach to implement the plan.

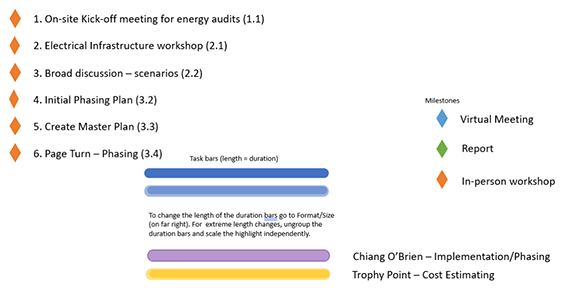

Clean Energy Master Plan workshops and phasing plans

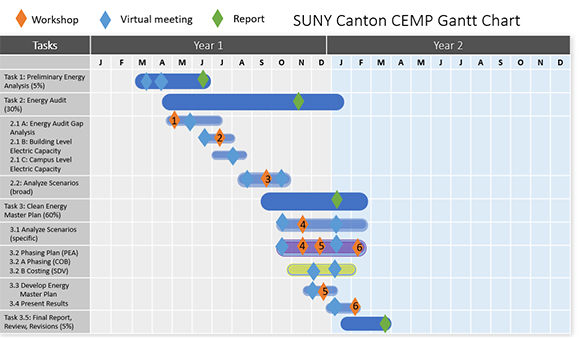

Clean Energy Master Plan Gantt Chart

L23159 Reconstruct Pedestrian Walks Payson, Rushton & Heritage Halls

Bid Phase anticipated Spring 2023.

L23160 Reconstruct Chaney Dining Hall Parking Lot

Bid Phase anticipated Spring 2023.

L23165 Replace Elevator Smith Hall

Bid Phase anticipated Fall 2022.

L23166 Reconstruct Multi-Use Path

Bid Phase anticipated Spring 2023.

Future Project Starts

231050-00 Renovate Payson Hall

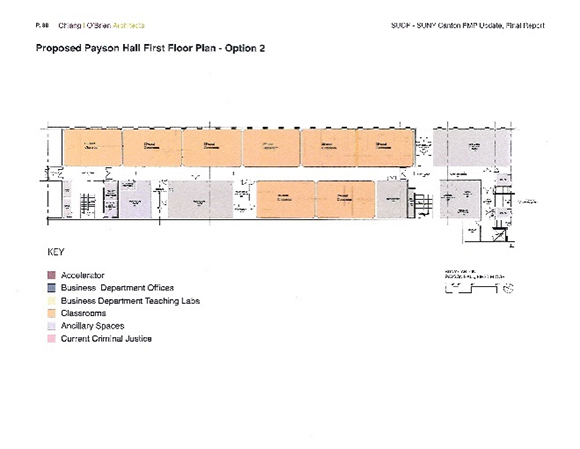

Payson Hall Renovation - Option 2 - Floor 1

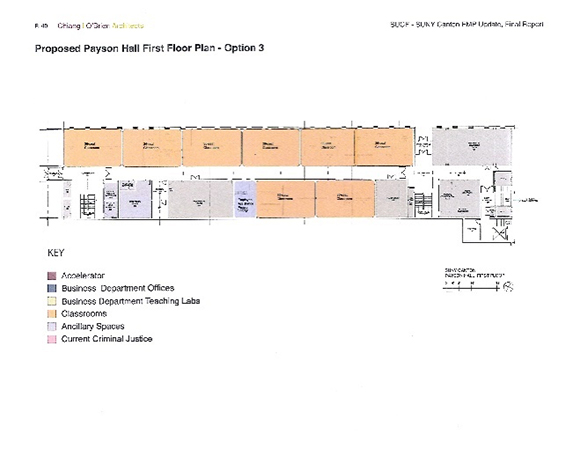

Payson Hall Renovation - Option 2 - Floor 2

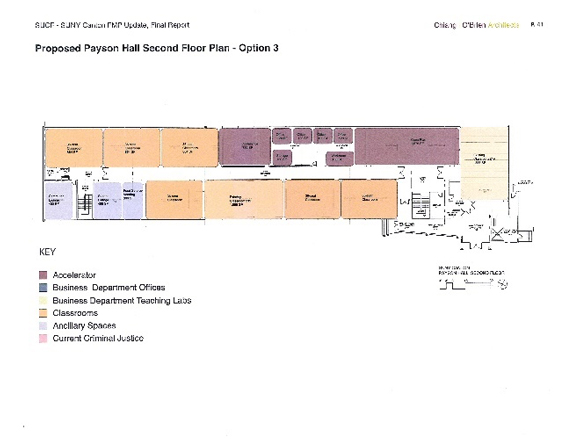

Payson Hall Renovation - Option 3 - Floor 1

Payson Hall Renovation - Option 3 - Floor 2

2310XX-00 Upgrade French Hall Plaza Phase III

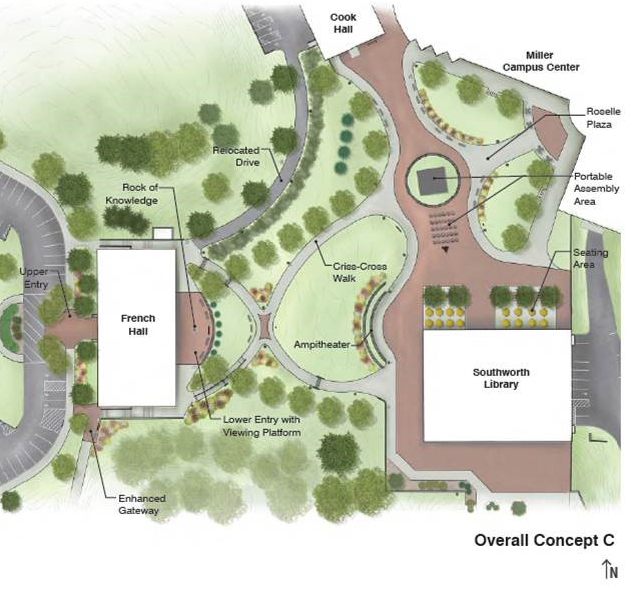

Roselle Plaza artist rendering

2310XX-00 Reconstruct Parking Lot No. 4

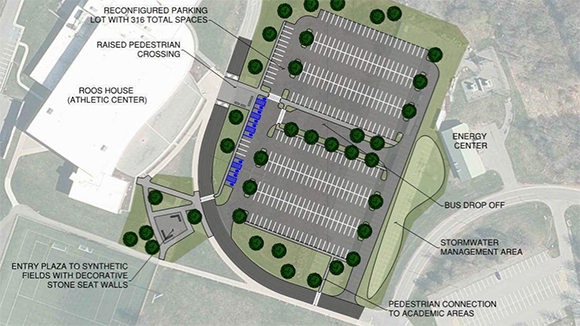

Roos House Parking Lot 4

Cooper Service Complex
34 Cornell Drive
